Skip to main content

Bainbridge Island's existing electric system

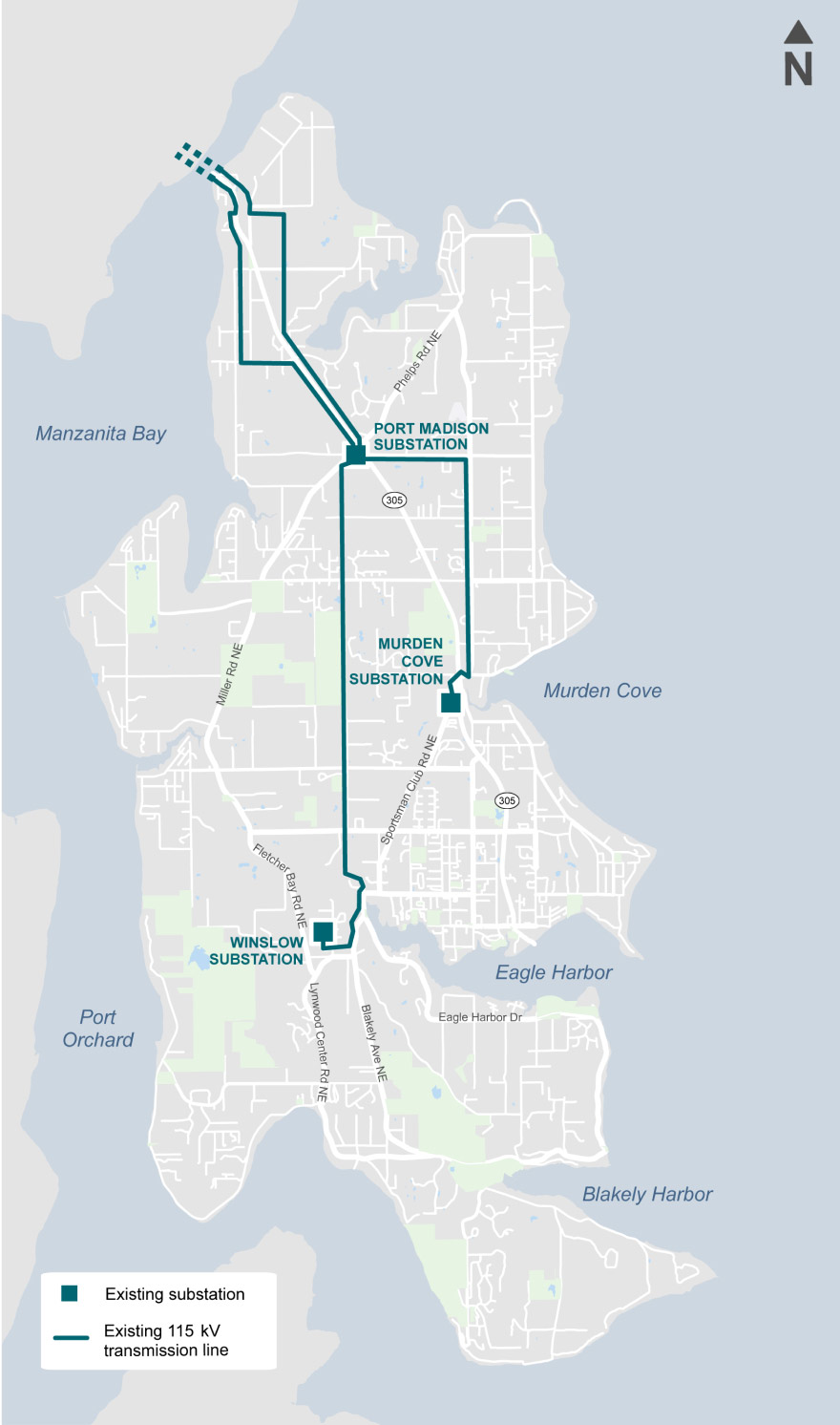

Four transmission lines and three substations serve approximately 14,500 residences, businesses and other points of connection.


Bainbridge Island's existing electric system

Two high-voltage (115 kV) overhead transmission lines transport power across Agate Pass to Port Madison Substation. From Port Madison Substation, the Murden Cove transports power to Murden Cove Substation, and the Winslow transports power to Winslow Substation.

project overview map
Click to enlarge

How power gets to you

Click through the slider to learn how power gets to you!

Did you know Bainbridge Island has 322 miles of distribution lines, 56% of which (186 miles) are underground?

The Island’s electric system needs

In 2019, PSE completed a detailed assessment of Bainbridge Island’s electric system needs and identified the need for improved transmission reliability and increased capacity.


Improved reliability

Reliability means fewer power outages for customers – or outages that don’t last as long.

Bainbridge Island customers experience longer and more frequent outages in comparison to customers in Kitsap County and PSE company-wide due to:

Lack of redundancy

Nearly two-thirds of Bainbridge Island customers are at risk of a prolonged outage (as shown in the animation). This is because their area is served by a substation that’s fed by a single transmission line with no back-up. If the transmission line serving the substation goes out, then the substation and all customers served by that substation lose power.

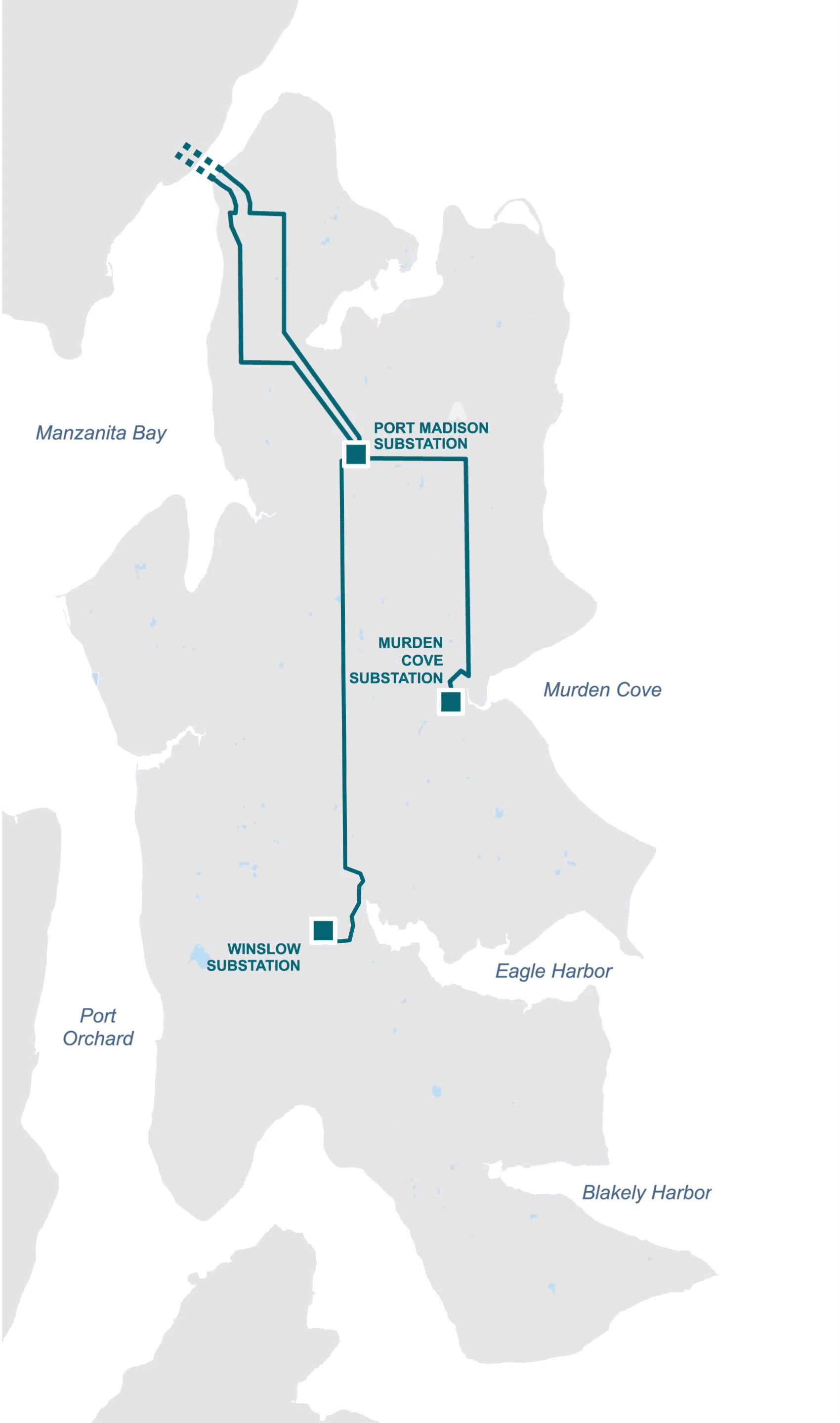

map GIF

Aging equipment

The Winslow Tap transmission line was built in the 1960s. Some of its poles and equipment are nearing the end of their life and need to be replaced.

Trees & difficult access

Bainbridge Island’s transmission lines are heavily exposed to trees. Trees cause most of the Island’s outages - when branches touch power lines or when trees fall into lines.

In particular, portions of the Winslow Tap transmission line are located in a heavily-vegetated corridor with difficult terrain and protected wetlands and streams, which makes it challenging to respond to outages compared to the other transmission lines on the Island.

Increased capacity

Capacity, put simply, is whether the electric system can meet power demand.

Electricity demand on Bainbridge Island is growing due to:

Population

Since the 1950s (when much of this electric infrastructure was built), the Island’s population has grown from just under 1,000 residents to nearly 25,000.

Increasing electrification

  • Electric vehicle and appliance use has been growing on Bainbridge Island. We’re increasingly relying on electricity to power our daily lives, especially during the coldest and hottest times of year.
  • Washington State Ferries is transitioning to a hybrid electric ferry system. This will require additional power for the Bainbridge Island ferry terminal.

“Winter peak” refers to the time in which the highest amount of electricity is used during the winter. Bainbridge Island’s winter peak occurs in the morning and typically on the coldest days of the year due to the increased use of heating.

A hybrid solution

In 2019, we announced our solution to address the Island’s electric system needs. We are taking a “hybrid” approach, combining new grid infrastructure and energy efficiency programs, to increase the Island’s electric reliability and capacity. PSE is committed to working with the community on implementing this hybrid solution.


Reliability

The following projects are intended to work together to make the Island’s electric grid more resilient and reduce the impact of outages by adding redundancy to the system.

  1. 1 New Murden Cove – Winslow 115 kV transmission line
  2. 2 Winslow Tap transmission line rebuild
  3. 3 Upgrades at Murden Cove and Winslow substations
    While not part of the hybrid solution, PSE made upgrades at Port Madison Substation in 2023 and 2024.

Capacity

The following project and program are intended to address the Island’s increasing power needs and reduce demand on the grid.

  • Second transformer at Murden Cove Substation
  • Flex Smart+ (demand response program)

Other projects

In addition to the hybrid solution projects, PSE is investing in other projects to improve Bainbridge Island’s distribution system reliability and capacity. Visit our website to check out our full list of current projects.

Conservation is key to helping PSE meet the Island's energy capacity needs. PSE proposes 3.3 MW of the Island's capacity need come from distributed energy resources (DERs) like PSE's demand response program, Flex Smart+. Learn more about Flex Smart+ on slide 8.

However, the demand for energy is growing faster than conservation efforts can keep up with, and conservation only helps in reducing capacity need. It doesn't address reliability.

*To meet this capacity goal, enough Bainbridge Island customers must participate in PSE's conservation and demand response programs. If there's not enough participation and we don't meet our 3.3 MW goal, PSE may need to add more infrastructure to support the Island's capacity needs.

Check out other frequently asked questions (FAQs)

Hybrid solution projects

hybrid solutions map
Map elements are not to scale and locations are approximate | Click map to enlarge.

Schedule

We will continue to keep property owners and the community informed of progress on projects, construction impacts and additional opportunities to engage.


Below is our current schedule for the Flex Smart+ program and construction on our hybrid solution infrastructure projects. Currently, we are working on design and permitting on all of our infrastructure projects.

2022 2023 2024 2025 2026 2027 2028 2029
Flex Smart+* Capacity Project Capacity Project Capacity Project Capacity Project Capacity Project Possible Capacity Project Possible Capacity Project Possible Capacity Project
Murden Cove Substation upgrades Capacity Project Capacity Project
Winslow Tap rebuild Reliability Project Reliability Project
Winslow Substation upgrades Reliability Project
New Murden Cove - Winslow 115 kV transmission line Reliability Project Reliability Project

This schedule could change, depending on the progress of permitting.

*The Flex Smart+ program may be extended beyond 2026.

Blue
Capacity project
Orange
Reliability project
Red
Capacity & reliability project

Reliability | New Murden Cove – Winslow 115 kV transmission line

This project will improve reliability for two-thirds of the Island, including families, schools and businesses.


Overview

We plan to install a new 115 kV transmission line between the Murden Cove and Winslow substations to create a transmission loop. Each substation will connect to two transmission lines. If one line goes out, the other line can still feed the substation and provide power to customers.

Planning process

In 2019, we began seeking the community's feedback on siting the new transmission line through a Community Sounding Board, online community workshops, information sessions, an interactive route explorer and comment portal, mailings and more.

After more than two years of technical analysis and community engagement, we selected this route (shown on the map) because it best meets PSE’s operational needs while balancing community values shared during the engagement process.

The selected route follows PSE’s existing distribution system in the road right-of-way. This means we can collocate the transmission line over existing distribution lines, limiting impacts to private property and environmental resources.

Timeline

  • Fieldwork and design: Ongoing through early 2025
  • Real estate acquisition: Early 2025 through late 2026
  • Permitting: Late 2026 through late 2027
  • Construction: 2028 – 2029

New 115 kV transmission line

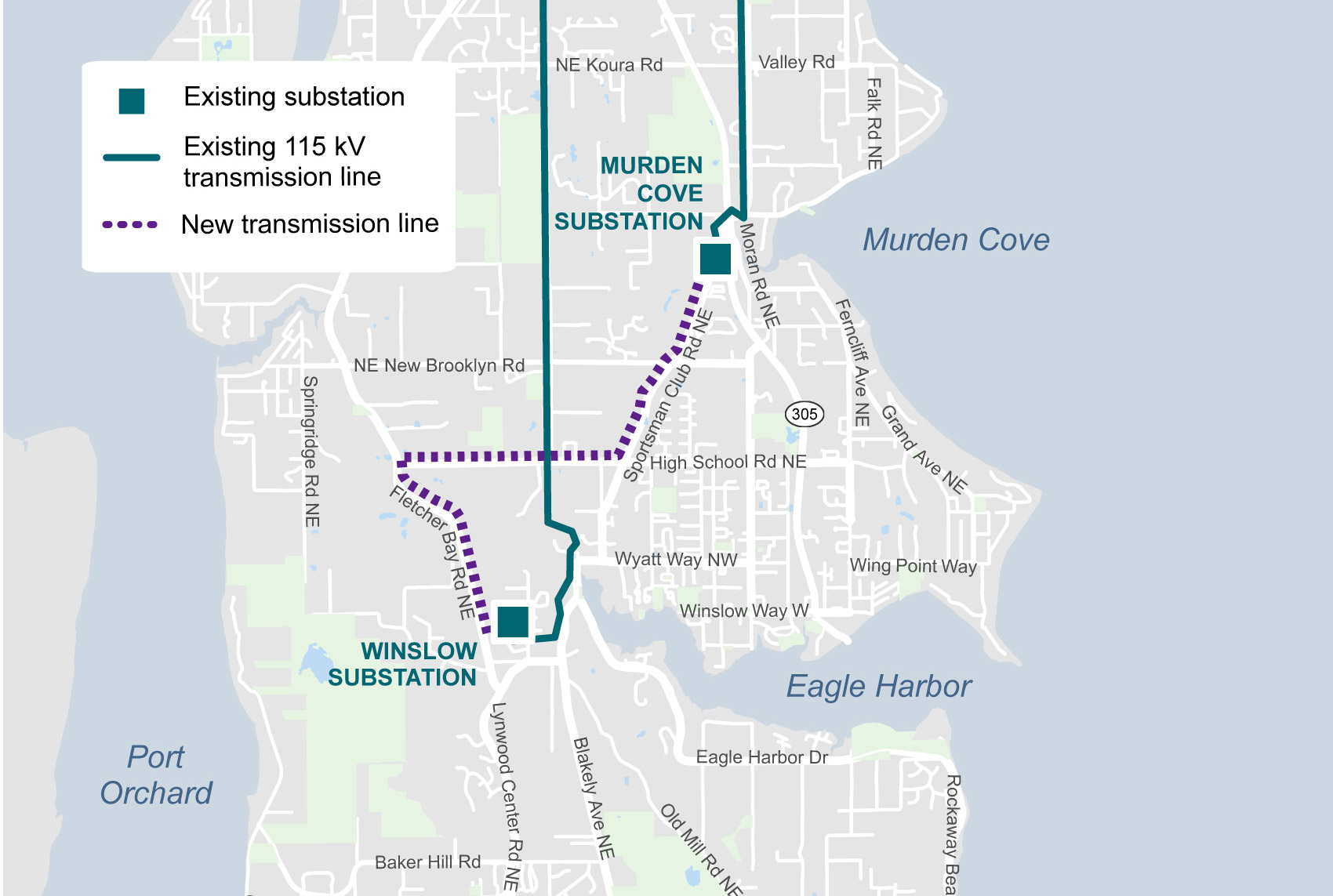

New 115 kV Transmission Line map
Map elements are not to scale and locations are approximate | Click map to enlarge.

Want to learn more about the Murden Cove – Winslow 115 kV transmission line? Visit the project website.

PSE can underground transmission lines, but under PSE’s Electric Tariff G Schedule 80, underground transmission lines are considered a “local option” and the community must pay the cost difference between overhead and underground lines. Most communities decide not to invest in undergrounding transmission lines because they have other investment priorities.

If the City of Bainbridge Island is interested in cost sharing, we can explore that option. To-date, PSE has not received any indication that the City would like to pursue this.

PSE hosted a community-wide information session on undergrounding during the routing process for the new Murden Cove – Winlsow 115 kV transmission line. Check out our undergrounding transmission lines factsheet here to learn more.

Photo renderings

Please note, the photo renderings are for discussion purposes only and may change pending public, regulatory and utility review.

Sportsman Club Road rendering
Click to enlarge.

Location: Sportsman Club Road looking south from the north entrance to Woodward Middle School

Sportsman Club Road rendering
Click to enlarge.

Location: Sportsman Club Road Looking south toward the Sportsman Club

High School Road rendering
Click to enlarge.

Location: High School Road looking east from intersection of Fletcher Bay Road and High School Road

Fletcher Bay Road rendering
Click to enlarge.

Location: Fletcher Bay Road looking north along existing distribution near driveway for 6895 Fletcher Bay Road

Fletcher Bay Road rendering
Click to enlarge.

Location: Fletcher Bay Road looking north along existing distribution line

Reliability | Winslow Tap transmission rebuild

This rebuild project will reduce the number and duration of outages, serving customers reliably into the future.


Overview

PSE plans to rebuild portions of the existing 4.5-mile Winslow Tap 115 kV transmission line. The Winslow Tap is the only transmission line serving the Winslow Substation, which supplies power to approximately 4,500 homes and businesses on the south end of the Island.

The transmission line was built in 1960 and certain equipment is nearing the end of its useful life and needs to be replaced. In addition, portions of the line are located in a heavily-vegetated corridor with difficult terrain and protected wetlands and streams, which makes it challenging to respond to outages.

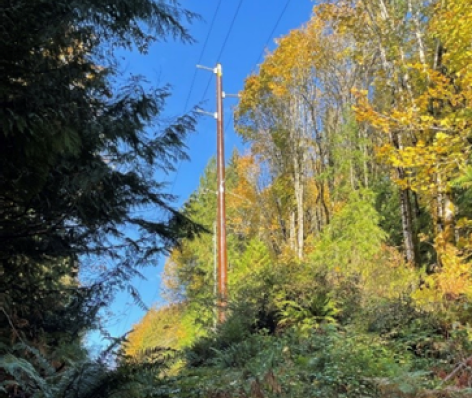

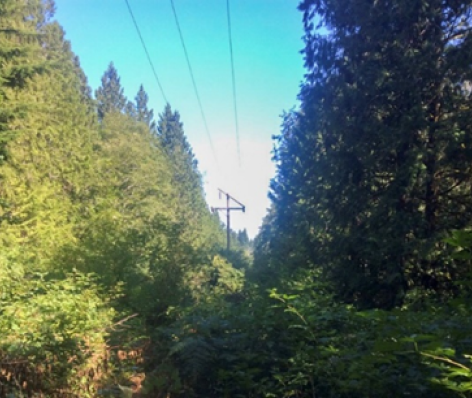

Vegetation along the existing Winslow Tap transmission line corridor.
Vegetation along the existing Winslow Tap transmission line corridor.
Example of fiberglass replacement pole for wetland areas.
Example of fiberglass replacement pole for wetland areas.

We will replace some existing poles and equipment, install new wire and improve safety and access along the corridor. This work will reduce the number and duration of outages, serving customers reliably into the future.

Timeline

  • Permitting: Ongoing through 2027
  • Real estate acquisition: 2025 - 2026
  • Construction: 2027 - early 2028

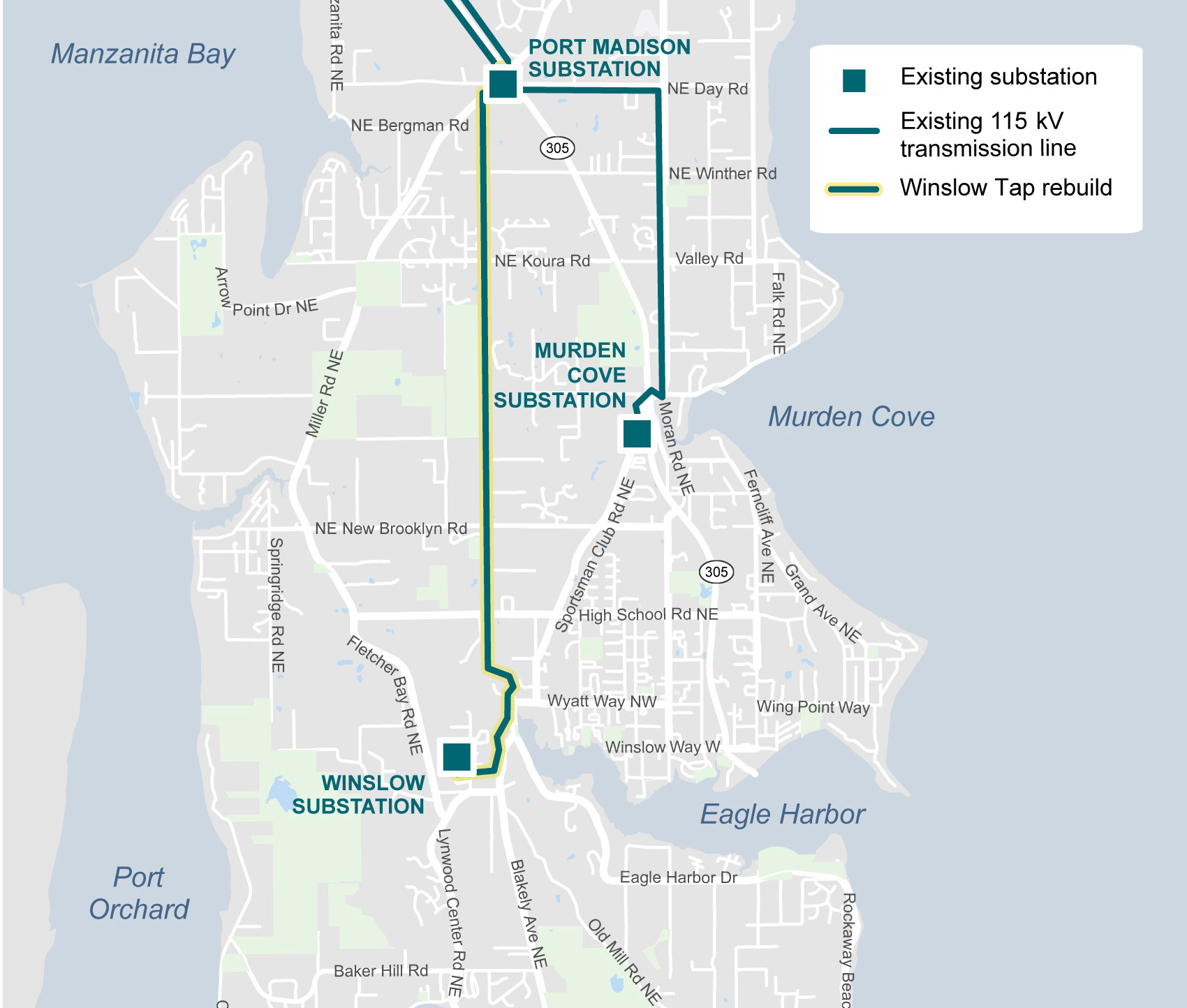

Existing Winslow Tap

Existing Winslow Tap map
Map elements are not to scale and locations are approximate | Click map to enlarge.

Want to learn more about the Winslow Tap transmission rebuild? Visit the project website.

Reliability and capacity | Upgrades at Murden Cove and Winslow substations


Overview

To improve reliability, PSE plans to upgrade the Murden Cove and Winslow substations. These upgrades will support the new Murden Cove – Winslow 115 kV transmission line.

In addition, PSE plans to install a second transformer within the Murden Cove Substation to provide electric capacity to meet our customers’ current and future energy needs.

Timeline

Murden Cove Substation

  • Fieldwork and design: Ongoing through 2024
  • Permitting: 2024
  • Construction: 2025 - 2026

Winslow Substation

  • Fieldwork and design: Ongoing through 2024
  • Permitting: 2025
  • Construction: 2028

Want to learn more about the upgrades at Murden Cove and Winslow substations? Visit the project website.


Yes, there’s enough electric capacity coming onto the Island. Around ten years ago, PSE rebuilt and increased the electric capacity of the two transmission lines that carry power across Agate Pass to Port Madison Substation on Bainbridge Island. At the time, the lines were reaching their capacity limit.

With the increased capacity, these two transmission lines can reliably supply power to Bainbridge Island, even during times of high power usage or during an unplanned outage on another nearby transmission line.

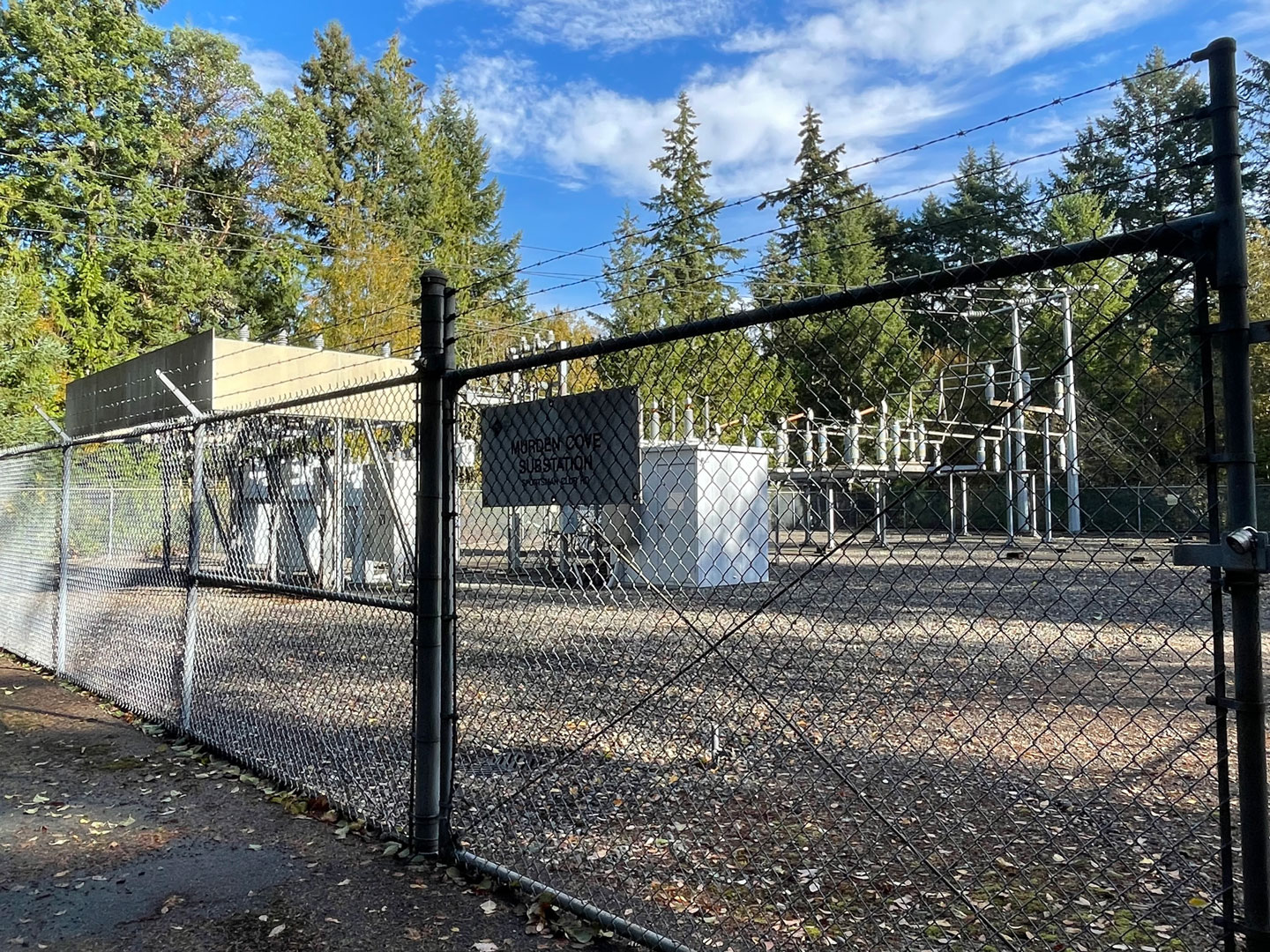

What does a substation look like?

Murden Cove Substation
Murden Cove Substation

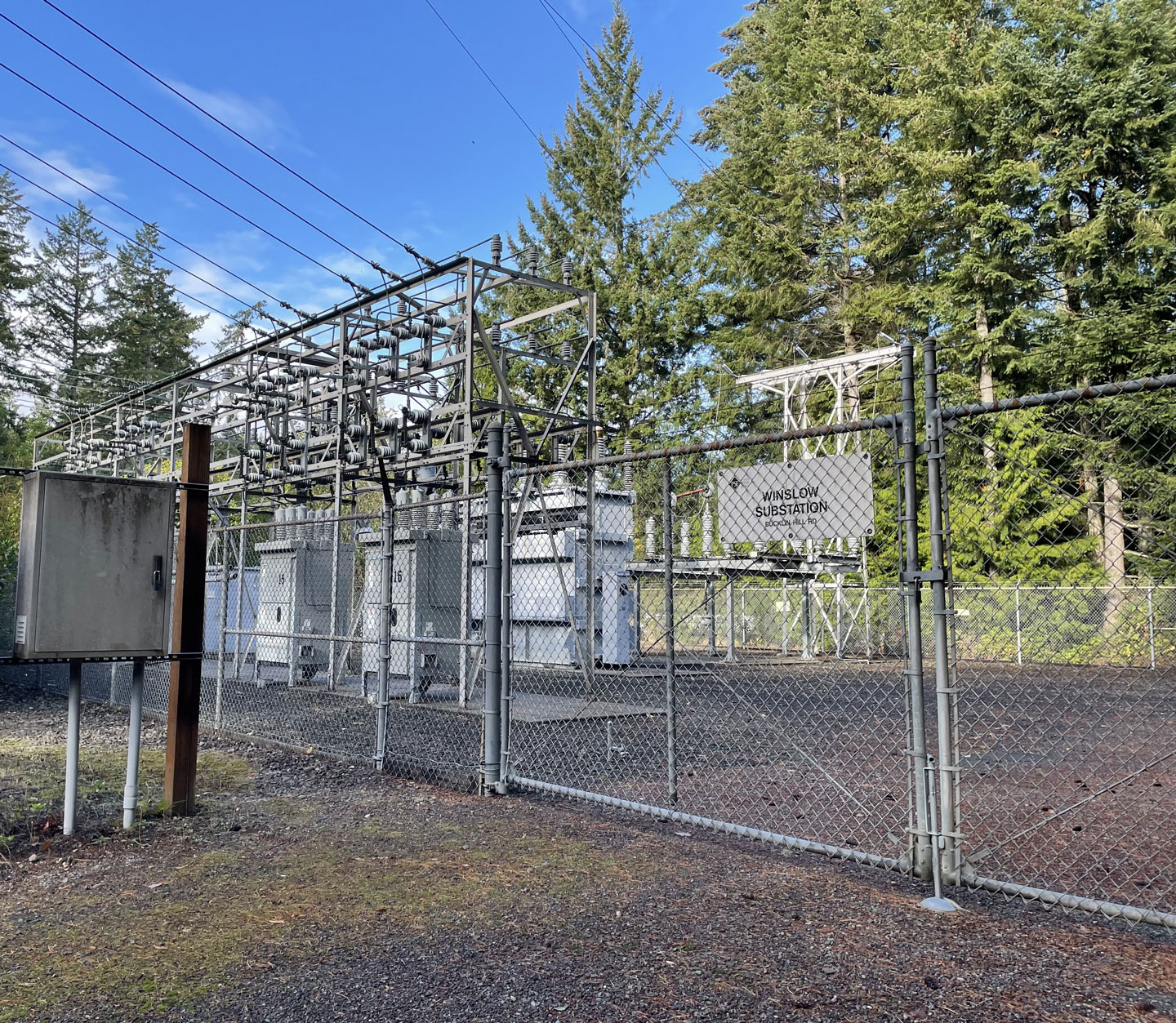

Winslow Substation
Winslow Substation

Capacity | Flex Smart+

Flex Smart+ is a voluntary energy efficiency pilot program for Bainbridge Island residents who heat and/or cool their homes with electricity. PSE launched the program in late 2022 to help meet the Island’s growing demand for energy.


How it works

  • Ahead of extra cold or hot weather, we’ll adjust your smart thermostat’s temperature setting for a few hours. This is called a “Flex event.”
  • Don’t worry, you’ll stay comfortable and you can always opt out. Flex events allow us to work together to prevent spikes in energy usage and smooth out demand.
  • Get $75 for joining the program and up to $50 per thermostat you enroll, plus more for staying enrolled. You’re also eligible for higher rebates on heating equipment, insulation, windows and more to make your home more energy-efficient.
  • Don’t have a smart thermostat? You can get a qualifying smart thermostat installed through Flex Smart+ with a $350 rebate.

Sign up now!

Visit Flex Smart+ and sign into your PSE account to see if you are eligible for the program.

PSE Flex Smart+

A flexible approach to meeting our region's growing energy needs.

Flex Smart

We need your help!

To meet our 3.3. MW capacity reduction goal, enough Bainbridge Island customers need to participate in Flex Smart+ and PSE’s other conservation programs. If there’s not enough participation and we don’t meet our 3.3 MW goal, PSE may need to add more infrastructure to support the Island’s capacity needs.

Interactive map

Explore this interactive map to view PSE’s existing electric infrastructure on the Island, the projects in our hybrid solution and photo renderings of the new Murden Cove - Winslow 115 kV transmission line.

Please note, the photo renderings are for discussion purposes only and may change pending public, regulatory and utility review.


Next steps

For the past three years PSE has worked with the City of Bainbridge Island to identify and request code amendments to ensure we can continue to provide reliable electric service to Bainbridge Island residents and businesses.

In September 2024, the Bainbridge Island City Council approved the code amendments. PSE is now working on updating our project permit documentation to reflect the newly adopted codes.

We expect to begin real estate acquisition for the two transmission line projects, beginning with the Winslow Tap transmission rebuild, in fall 2024. PSE must obtain all necessary easement rights before we can submit permit applications and begin construction on these projects.

Working with property owners

PSE communicates with property owners about any impacts associated with installing, operating and maintaining our facilities on Bainbridge Island. Below we provide more information about what affected property owners can expect during easement acquisition and construction.


Easement acquisition

PSE needs to acquire permanent easement rights on some private properties along our transmission line projects to be able to install, operate and maintain our facilities and manage vegetation. Permanent easement rights ensure we have efficient and safe access to our facilities so we can keep reliable power flowing to you.

Transmission line construction process

It’s too early to know what the construction staging and impacts will look like for the Winslow Tap transmission rebuild and new Murden Cove – Winslow 115 kV transmission line. Once we have final designs for each of these transmission line projects, we will be able to share more specific details about construction.

Our typical construction process:

  • Pre-construction field surveying.
  • Site preparation and access (including vegetation trimming and removal).
  • Installing the new transmission or distribution poles and removing the old ones.
  • Stringing the transmission or distribution line conductors (wires).
  • Cleaning up, restoring and replanting vegetation.

PSE works with property owners and the community to minimize environmental, traffic, noise and other construction impacts. Once construction is complete in an area, PSE restores property affected by construction to its previous or an improved state, as practical. When restoration is not possible, we work with property owners to determine other options.

What to expect during the easement process

If PSE needs to acquire easement rights on your property, a PSE right of way agent will reach out to work through the process with you. Generally, the steps include:

  • We make initial contact with you.
  • We provide an easement offer package to you.
  • You review the easement package.
  • You have an opportunity to discuss the easement package with a PSE right of way agent.
  • You sign our easement document(s) in presence of a notary public.
  • We pay you for the easement.
  • We record the easement document(s) with the county.
  • We provide a copy of the easement document(s) to you.

You have our guarantee that we will:

  • Work with you in good faith and in an ethical manner.
  • Provide just compensation for the necessary easement rights, including any necessary tree removal.

Safety is PSE’s top priority. We take careful steps to ensure we can construct our projects in a safe and efficient manner.

Stay involved
